Indoor Playground Installation: What Does the Process Include?

Views: 0     Author: Site Editor     Publish Time: 2026-09-02      Origin: Site

Inquire

facebook sharing button
twitter sharing button
line sharing button
wechat sharing button
linkedin sharing button
pinterest sharing button
whatsapp sharing button
sharethis sharing button

Indoor playground installation usually includes much more than assembling slides, climbing frames and soft-play components. A complete project may involve requirement communication, site measurement, layout planning, 3D visualisation, engineering drawings, material preparation, production, packing, shipping, on-site installation, final inspection and after-sales support.

The installation result depends heavily on the earlier design and production stages. If the venue dimensions are inaccurate, the age zones are not defined or the final drawings are not approved clearly, problems may appear when the equipment reaches the site. For this reason, buyers should choose an installation supplier that can coordinate the project from the first discussion through final handover.

A well-managed indoor playground equipment for business project should have clear responsibilities, documented approvals and a practical schedule for every stage.

Key Takeaways

  • Indoor playground installation begins with project requirements and site information.

  • CAD layouts help confirm equipment positions, circulation and age zoning.

  • 3D renderings allow buyers to review the appearance before production.

  • Engineering drawings translate the approved concept into manufacturing and installation instructions.

  • Production should follow the final approved drawings and equipment list.

  • Shipping requires clear packing, labelling and component records.

  • Site installation depends on venue readiness, access conditions and technical coordination.

  • Final acceptance should check the installed equipment against the approved design.

  • After-sales support should cover maintenance guidance, replacement parts and technical questions.

  • The buyer should remain involved throughout the approval and inspection process.

What Does Indoor Playground Installation Include?

A typical commercial installation project can be divided into nine main stages:

  1. Requirement communication

  2. Site information collection

  3. Preliminary layout and design

  4. CAD floor-plan development

  5. 3D rendering and design approval

  6. Engineering drawings and production

  7. Packing, shipping and delivery

  8. On-site installation

  9. Final acceptance and after-sales support

The exact number of steps may vary by project size and supplier. A small soft-play area may require a simpler process, while a multi-zone indoor playground may require several rounds of design review and more detailed engineering coordination.

The important point is that installation should be treated as part of a complete project workflow. The equipment, flooring, barriers, entrances, circulation routes and parent seating all need to work together.

A supplier that only discusses delivery dates may not be providing enough project support. Before placing an order, confirm who will handle design, manufacturing, shipping, installation, inspection and future maintenance.

Step 1: Communicate Project Requirements

The first stage is to define what the buyer expects the playground to achieve.

Discuss the following points:

  • Venue location

  • Total floor area

  • Ceiling height

  • Target customer age groups

  • Expected visitor profile

  • Main equipment categories

  • Preferred theme

  • Parent seating requirements

  • Party room or reception needs

  • Budget range

  • Target opening date

  • Local building requirements

  • Installation restrictions

The target age group should be clarified early. A toddler zone may require low slides, soft obstacles, crawling features and sensory panels. A preschool or school-age zone may need climbing frames, bridges, obstacle features or more active equipment.

The business model also affects the design. A toddler-focused centre may prioritise comfort, visibility and easy cleaning. A larger family entertainment venue may need multiple attractions to encourage longer visits and serve different age groups.

At this stage, the buyer should also explain whether the project is a new venue, a renovation or an equipment upgrade. Existing structures, flooring and electrical systems may affect the final design.

Clear communication at the beginning reduces the risk of choosing equipment that later needs to be removed or redesigned.

Step 2: Collect Accurate Site Information

The supplier needs accurate site information before preparing a detailed layout.

The buyer should provide:

  • Dimensioned floor plans

  • Ceiling height

  • Column locations

  • Entrance and exit positions

  • Emergency exits

  • Fire protection equipment

  • Lighting locations

  • HVAC systems

  • Floor levels

  • Walls and fixed structures

  • Loading and unloading access

  • Stairs, lifts and narrow doorways

  • Available storage space

Site photographs are useful, but they should not replace measurements. A photograph may not show a low beam, uneven floor, pipe, column or restricted access route.

The delivery route should also be considered. Equipment may need to pass through doors, corridors, lifts or stairways before reaching the installation area. Large components may require special packing or partial assembly.

The buyer should identify any building restrictions before the design is approved. For example, the venue may limit working hours, prohibit drilling in certain areas or require approval from the property owner.

Accurate site information gives the supplier a better basis for indoor playground design, equipment selection and installation planning.

Step 3: Prepare the Preliminary Layout

The preliminary layout shows how the equipment will be organised inside the venue.

The design should address:

  • Main entrance

  • Toddler area

  • Preschool area

  • School-age area

  • Active-play zone

  • Quiet-play zone

  • Parent seating

  • Reception and ticketing

  • Party rooms

  • Staff routes

  • Storage

  • Cleaning access

  • Emergency routes

The preliminary layout should not focus only on the equipment footprint. It must also show the empty space required for movement, supervision, access and safety.

For example, a slide requires more than the space occupied by the slide itself. The access route, landing area and surrounding circulation must also be considered. A climbing structure may require additional space for safe movement and inspection.

Age zoning is another important decision. Younger children should not share direct routes with older children using faster or higher equipment. A protected toddler area can improve supervision and reduce movement conflicts.

The layout should also consider how visitors enter and leave the playground. A clear flow prevents congestion at the entrance, reception desk, shoe-storage area and most popular attractions.

Step 4: Review the CAD Floor Plan

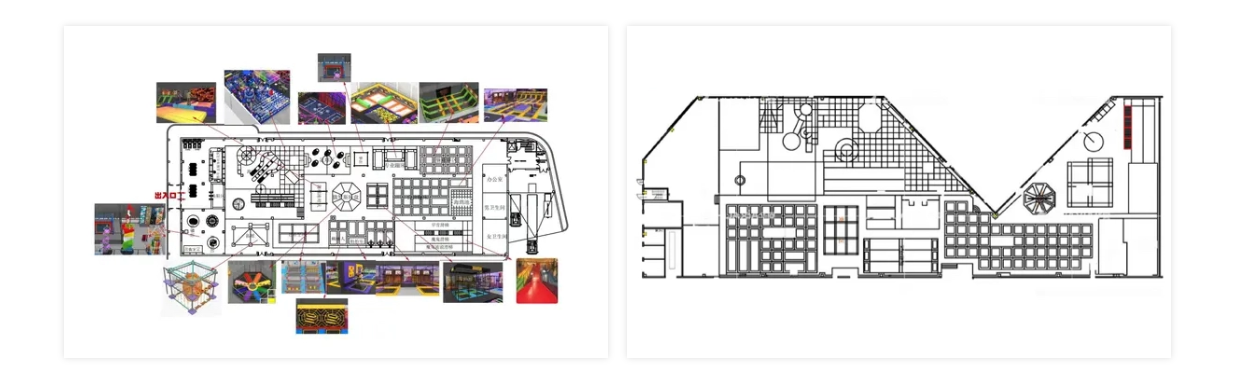

CAD Layout Design Proposal

After the preliminary concept is agreed, the supplier may prepare a CAD floor plan.

A CAD layout should allow the buyer to review:

  • Exact equipment positions

  • Dimensions

  • Distances between attractions

  • Use zones

  • Circulation paths

  • Parent seating

  • Staff access

  • Emergency routes

  • Structural obstacles

  • Entrance and exit locations

The buyer should compare the CAD plan with the actual venue. Confirm that the drawing includes all columns, walls, doors, stairways and fixed building services.

Check whether the design leaves enough space for parents to enter the play area. A layout may appear efficient from above but become difficult to supervise when the structure blocks the main viewing lines.

The buyer should also review whether maintenance staff can reach the equipment. Hidden corners, enclosed areas and tightly packed components may make routine inspection or cleaning more difficult.

Do not approve the CAD drawing simply because the equipment arrangement looks attractive. Ask practical questions:

  • Can parents see the main activity areas?

  • Can staff reach every zone quickly?

  • Are toddler and older-child routes separated?

  • Are slide landings clear?

  • Is there enough space for queues?

  • Can damaged components be removed?

  • Is the cleaning route practical?

  • Does the design allow future changes?

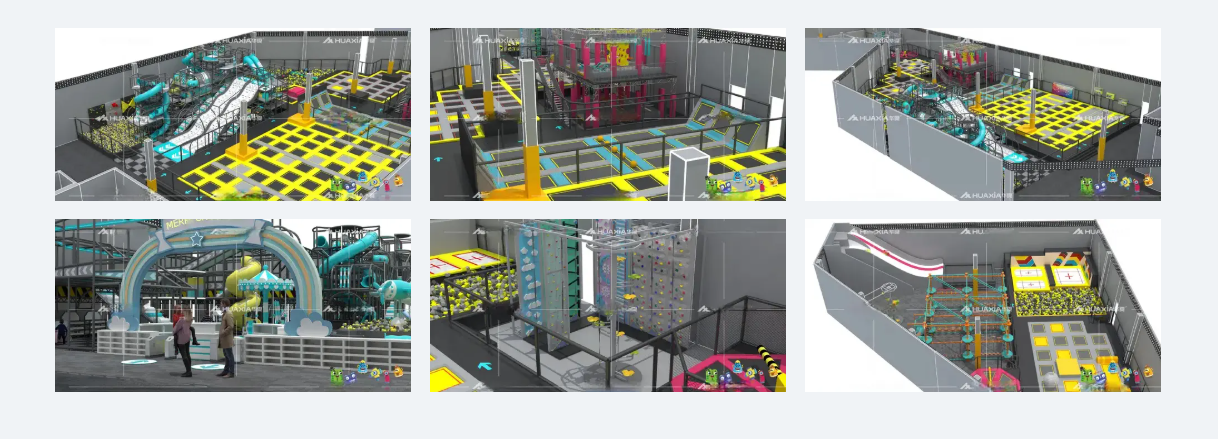

Step 5: Review the 3D Rendering


A 3D rendering helps the buyer understand how the completed playground may look from different viewpoints.

The buyer can use the rendering to review:

  • Theme and colour combinations

  • Equipment height

  • Visual balance

  • Entry appearance

  • Parent seating visibility

  • Relationship between age zones

  • Decorative elements

  • Lighting effect

  • Brand integration

  • Customer photo opportunities

A rendering is useful for design communication, but it is not a substitute for technical drawings. Some details may be simplified in the visual presentation. The buyer should compare the 3D image with the CAD plan and equipment list.

Pay attention to elements that may look attractive but create operational problems. Tall decorative panels can obstruct visibility. Enclosed themed houses can create hidden areas. Large signs may interfere with lighting or cleaning access.

The best design approval process uses the 3D rendering to confirm the visual direction and the CAD plan to confirm the practical layout.

VASIA’s design process describes the use of concept communication, CAD layout proposals, 3D design renderings, 3D walkthrough videos and engineering drawings. Buyers should ask their supplier whether a similar sequence is available for the project.

Step 6: Approve Engineering Drawings

Engineering drawings translate the approved design into information that can be used for production and installation.

Depending on the project, the drawings may show:

  • Structural positions

  • Platform levels

  • Connection points

  • Component dimensions

  • Slide locations

  • Barrier positions

  • Access routes

  • Flooring areas

  • Support requirements

  • Installation sequences

  • Component labels

The engineering drawings should match the final CAD plan and 3D rendering. If the buyer notices a difference, the issue should be resolved before production begins.

Before approval, confirm:

  • The latest version is being reviewed

  • All design changes are included

  • The equipment list is complete

  • Age zones are correctly identified

  • Safety clearances are shown

  • Installation access is practical

  • Local site restrictions are considered

  • The correct person is responsible for approval

Engineering drawings are particularly important for custom projects. Custom indoor playground equipment may contain different dimensions, routes or connection details than a standard package.

A written approval record can prevent confusion later. Keep the final drawings, equipment schedule and approved colour or material references together.

Step 7: Production and Quality Inspection

After the drawings are approved, the supplier can begin production.

Production may include:

  • Structural component preparation

  • Platform and frame assembly

  • Padding production

  • Surface-covering work

  • Slide production

  • Interactive-panel preparation

  • Themed decoration

  • Hardware preparation

  • Component labelling

  • Pre-shipment inspection

The production team should work from the approved drawings rather than an earlier concept. This is why revision control matters.

Ask how the supplier checks:

  • Dimensions

  • Structural connections

  • Padding coverage

  • Surface finish

  • Colour consistency

  • Component quantity

  • Moving parts

  • Hardware

  • Labels

  • Packing condition

For larger projects, the buyer may request production photographs or progress updates. These updates can help identify differences before shipment.

The final inspection should compare the completed equipment with the approved equipment list. Missing or incorrectly labelled components can slow installation and create additional costs at the site.

A professional commercial indoor playground equipment supplier should be able to explain how production, inspection and packing are connected.

Step 8: Packing, Shipping and Delivery

Indoor playground equipment is usually delivered in multiple components. Correct packing and labelling are essential.

Before shipping, confirm:

  • Packing list

  • Component labels

  • Package numbers

  • Equipment quantities

  • Shipping documents

  • Delivery terms

  • Loading photographs

  • Damage-reporting process

  • Unloading requirements

  • Site storage arrangements

Similar-looking components should be labelled clearly. This helps the installation team identify each item according to the engineering drawings.

The buyer should prepare the site before delivery. Confirm that the entrance, loading area, storage space and installation area are accessible.

Also check whether the venue has restrictions on delivery vehicles, working hours or temporary storage. If the equipment cannot be moved directly into the venue, a separate handling plan may be required.

When the shipment arrives, inspect the external packaging before opening it. Record visible damage and compare the packages with the packing list.

Step 9: On-Site Installation

On-site installation begins after the venue is ready and the equipment has been delivered.

The installation team may need to:

  • Unpack and sort components

  • Confirm the layout

  • Assemble the structural frame

  • Install platforms and barriers

  • Attach slides and climbing features

  • Install soft-play components

  • Fit interactive elements

  • Install padding

  • Position flooring

  • Check connections

  • Remove packaging waste

  • Complete final adjustments

The installation method depends on the equipment design and site conditions. Some projects may be installed by the manufacturer’s team, while others may use local contractors supported by technical drawings.

Before work begins, confirm:

  • The latest drawings are available

  • The floor is ready

  • The installation area is clear

  • Lighting is sufficient

  • Required tools are available

  • Safety procedures are understood

  • Other contractors are coordinated

  • The working schedule is agreed

The installation team should not make significant layout changes without approval. If an unexpected column, pipe or building restriction affects the design, the issue should be documented and reviewed before modification.

An experienced team of indoor playground builders should understand how to follow the approved layout while responding carefully to real site conditions.

What Should the Buyer Check During Installation?

The buyer or project representative should remain involved during installation.

Important checks include:

  • Equipment is placed according to the approved layout

  • Age zones are correctly separated

  • Slide entrances and exits are unobstructed

  • Barriers and gates are correctly positioned

  • Padding covers intended contact areas

  • Flooring transitions are secure

  • Parent viewing lines remain open

  • Staff routes are accessible

  • Emergency paths are not blocked

  • Decorative elements match the approved design

  • Components are not missing or damaged

The buyer should keep a record of any changes made during installation. A simple site record can include photographs, component numbers, location details and the person responsible for the decision.

Do not wait until the final day to report a problem. Early communication gives the supplier more time to correct an issue without affecting the opening schedule.

Step 10: Final Acceptance and Handover

Final acceptance confirms whether the completed installation matches the agreed project requirements.

The acceptance process should review:

  • Overall layout

  • Equipment quantities

  • Dimensions

  • Age-zone arrangement

  • Structural connections

  • Padding and surface finish

  • Slide access and landing areas

  • Barriers and gates

  • Flooring

  • Interactive components

  • Signage

  • Parent seating

  • Cleaning access

  • Emergency routes

  • Visible damage

The buyer should compare the installed playground with the final CAD drawing, 3D rendering, engineering drawings and packing list.

Ask the supplier to provide handover information such as:

  • Final equipment list

  • Installation drawings

  • Maintenance instructions

  • Cleaning guidance

  • Inspection recommendations

  • Warranty information

  • Replacement-part information

  • Contact details for technical support

A professional installation is not complete simply because the equipment is assembled. The venue should be ready for safe operation, routine cleaning and future maintenance.

Step 11: After-Sales Support and Maintenance

After-sales service continues after the playground opens. Commercial equipment is used repeatedly and should be inspected and maintained as part of normal operation.

An indoor playground installation supplier should clarify how the operator can obtain:

  • Installation support

  • Maintenance advice

  • Replacement parts

  • Technical explanations

  • Inspection guidance

  • Repair recommendations

  • Updated drawings

  • Warranty assistance

The operator should establish daily, weekly and periodic inspection procedures. These may include checking padding, fasteners, flooring, barriers, slides, sensory elements and visible wear.

Cleaning procedures should also be documented. Different materials may require different cleaning methods, and improper products may damage surfaces.

VASIA’s After-sale System page presents installation support, professional installation drawings, after-sales follow-up and maintenance advice as parts of project support. Buyers should confirm which services are included in their own contract.

Indoor Playground Installation Process at a Glance

Project Stage

Main Output

Buyer Responsibility

Requirement communication

Project brief

Confirm business goals and target users

Site information

Floor plan and site data

Provide accurate dimensions and photographs

Preliminary design

Initial zoning and equipment plan

Review age groups and circulation

CAD layout

Detailed floor plan

Confirm equipment positions and clearances

3D design

Visual presentation

Approve theme, colours and appearance

Engineering drawings

Production and installation instructions

Approve the final technical version

Production

Finished equipment and components

Review progress and resolve changes

Shipping

Packed and labelled equipment

Prepare delivery route and storage

Installation

Assembled playground

Coordinate site access and inspect progress

Acceptance

Completed project handover

Compare installation with approved documents

After-sales

Maintenance and technical support

Establish inspection and cleaning procedures

Common Installation Problems to Avoid

Inaccurate Venue Measurements

Incorrect measurements can lead to blocked entrances, unsuitable equipment positions or insufficient clearance. Measure the site carefully and identify fixed structures before design approval.

Approving the Rendering Without Checking the CAD Plan

A 3D image may look excellent while hiding circulation or supervision problems. Always compare the rendering with the technical layout.

Changing the Design After Production Starts

Late changes may affect components, costs, shipping and installation. Confirm the final design before production begins.

Failing to Define Installation Responsibilities

Unclear responsibilities can create disputes over labour, travel, tools, site preparation and final adjustments.

Ignoring Delivery Access

Equipment may not fit through the planned route into the venue. Review doors, corridors, lifts, stairways and loading areas in advance.

Blocking Parent Sightlines

Decorative panels, tall structures and poorly positioned seating can make supervision difficult. Review visibility from the main parent areas.

Treating Handover as the End of the Project

Maintenance instructions, inspection procedures and replacement-part information should be collected before opening.

Conclusion

Indoor playground installation is a coordinated process that begins with project requirements and continues through design, production, delivery, assembly, acceptance and after-sales service.

The most important early steps are accurate site measurement, clear age zoning and careful review of the CAD layout. The 3D rendering helps confirm the visual direction, while engineering drawings provide the information required for production and installation.

Before shipment, verify the equipment list, packing and component labels. During installation, ensure that the venue is ready, the latest drawings are available and any site changes are documented. After assembly, compare the completed playground with the approved documents and establish a practical maintenance routine.

Choosing a supplier that can support design, manufacturing, installation and after-sales communication can make the project easier to control. The final goal is not simply to assemble equipment, but to create a safe, functional and maintainable commercial play environment.

FAQs

How long does indoor playground installation take?

The installation time depends on the project size, equipment complexity, venue conditions, delivery arrangements and installation method. A small play area may require a shorter process, while a multi-zone commercial playground may require more preparation and coordination.

What information does a supplier need before preparing a layout?

The supplier usually needs venue dimensions, ceiling height, columns, entrances, exits, emergency routes, lighting, ventilation, target age groups, preferred equipment and theme requirements. Site photographs and a dimensioned floor plan are also useful.

What is the difference between a CAD layout and a 3D rendering?

A CAD layout shows the technical arrangement of equipment, dimensions, circulation and use zones. A 3D rendering shows how the completed playground may look visually, including colours, themes and decorative elements.

Are engineering drawings necessary for a commercial playground?

Engineering drawings are useful because they translate the approved design into production and installation information. They can show component positions, connection points, platform levels, barriers and other technical details.

Who should install indoor playground equipment?

Installation may be completed by the manufacturer’s team, a professional contractor or a local installation team supported by the manufacturer. The buyer should confirm responsibilities, drawings, tools, site preparation and final inspection before ordering.

What should the buyer prepare before installation begins?

The buyer should prepare the floor, access route, lighting, storage space and working area. The venue should be clear of unnecessary obstacles, and the installation team should have access to the latest approved drawings.

How should the completed installation be inspected?

Compare the installed equipment with the final layout, engineering drawings, equipment list and approved visual design. Check equipment positions, age zones, clearances, padding, flooring, barriers, slide landings and emergency routes.

What does after-sales support usually include?

After-sales support may include technical questions, installation follow-up, maintenance guidance, inspection advice, warranty assistance and replacement parts. The specific scope should be confirmed in the purchase agreement.

Can the layout be changed during installation?

Minor adjustments may sometimes be necessary because of actual site conditions. However, significant changes should be reviewed and approved before modification to prevent problems with safety, circulation or equipment use zones.

Established in 2000, top5 playground equipment supplier in China. Manufacture indoor playground; trampoline park; rope course; ninja course...

QUICK LINKS

PRODUCTS

CONTACT US

  Yuanqu Road, Yang wan Industrial Park, Qiaoxia Town, Yongjia County, Wenzhou City, Zhejiang Province
  +86-18066498819
  +86-577-67499999
Leave a Message
Keep In Touch With Us
Copyright ©️ 2024 Huaxia Amusement Co., Ltd. Sitemap.
